Baltica 2 Nears Construction - Seabed Clearance Operations Underway in the Baltic Sea
Ørsted has launched preparatory offshore activities for the Baltica 2 offshore wind farm – the largest project of its kind in Polish waters. The ongoing seabed clearance, including the relocation of boulders and other subsea obstacles, marks a critical milestone ahead of the construction phase.
business power engineering maritime economy offshore pomerania news11 july 2025 | 07:17 | Source: Gazeta Morska | Prepared by: Kamil Kusier | Print

fot. PGE Baltica

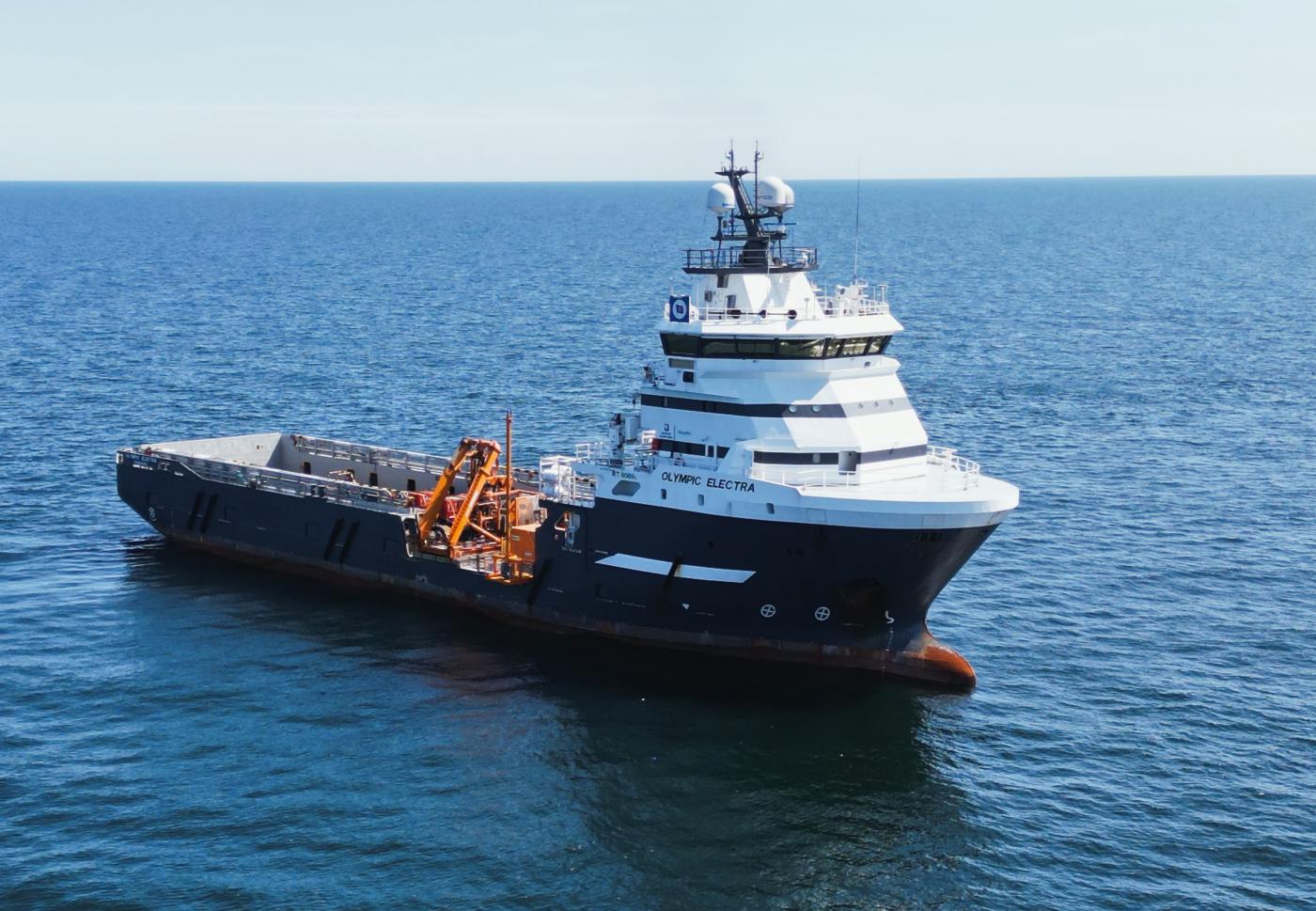

Currently operating in the designated area is the Olympic Electra vessel, which is carrying out boulder relocation along both turbine foundation zones and future export cable routes. The seabed preparation campaign is scheduled to continue through early 2026.
The vessel is equipped with a specialized boulder picking spread supplied by Utility ROV Services (UTROV). This advanced tool enables safe relocation of objects up to 3 meters in diameter, such as boulders, steel wires, lost fishing nets, and timber debris.
– These preparatory works at sea are the final stage before we move into full-scale construction. Boulder relocation directly impacts the safety and efficiency of subsequent phases – including foundation installation and deployment of subsea infrastructure – said Ulrik Lange, Vice President and Project Director of Baltica 2 at Ørsted. – As the offshore EPC lead and a company with over 30 offshore wind farms built worldwide, we’re excited to enter this advanced stage in the Baltic Sea.
According to PGE Baltica’s CEO Bartosz Fedurek, around 10,000 subsea objects are to be relocated during the campaign.
– Baltica 2 is now literally moving offshore. The clearance work paves the way for the installation of foundations and subsea components scheduled for 2026 and 2027. The project involves dozens of crew members, as well as supervision teams and specialists who have been involved since the seabed survey phase – Fedurek noted.
Once completed, the cleared seabed will allow for the deployment of scour protection systems and turbine foundations in 2026, followed by internal array cables and export cables in 2027.
The contract with UTROV was signed in 2025. The boulder relocation technology has already been successfully used in similar offshore operations across Europe.
Baltica 2 – A Milestone for Poland’s Offshore Wind Industry
Baltica 2, jointly developed by Ørsted and PGE, is poised to become Poland’s largest offshore wind farm with an installed capacity of up to 1.5 GW. Scheduled for commissioning in 2027, it will be capable of supplying green electricity to approximately 2.5 million Polish households. The project represents a major leap in the country’s transition toward renewable energy and sustainable power generation.
see also
Buy us a coffee, and we’ll invest in great maritime journalism! Support Gazeta Morska and help us sail forward – click here!
Kamil Kusier
redaktor naczelny
gallery
comments
Add the first comment
see also
A 1,112-metre pier into the sea at Lubiatowo has its environmental decision. Reactor vessels will arrive by sea
A third companion for Leviathan. Indratus, the former Game Changer, leaves Oceanco after a refit
Italy uses its 95-year-old tall ship to promote the nation. Poland has Dar Młodzieży and a quarrel over a quay
President signs the fuel windfall tax and demands cuts now. What it means for fishermen and ports
One bid for Gdynia's Outer Port. MSC wants the 5-billion-zloty terminal, three rivals walked away
Batavia goes ashore. The Dutch show what to do with a ship no longer worth keeping afloat
Gdańsk and New York sign a letter of intent. US trade is growing, a direct service is missing
A 240 million zloty dock and a new chief executive. Gryfia begins its modernisation programme
From one million to 38.6 million tonnes. Naftoport turns 35 and builds a berth for the largest tankers
Fake invoices worth 16 million zloty and 284 foreign workers. Suspect brought from Spain to Gdańsk
ADVERTISEMENT
ADVERTISEMENT
